September Tunnel Progress

September 15
Earlier this morning, the night shift team at Nishimatsu led S687 to breakthrough the d-wall at Kaki Bukit station, completing the BP bound tunnel between UBI and KKB. This is the third out of 4 TBMs to breakthrough under C929A.

September 20
TBM has launched at Tampines East C&C for the BP drive to Tampines Central station.

September 25
S758 has completed excavation of the Expo bound tunnel from Jalan Besar to Bencoolen station. The TBM will begin to dismantle within the tunnel.

September 25 - Completion of Expo bound tunnel
Tunnel Chart as of September 25
C925 TBM launches for the second and final drive to Tampines Central
September 22 - BBQ Celebration for S687 Breakthrough at 929A

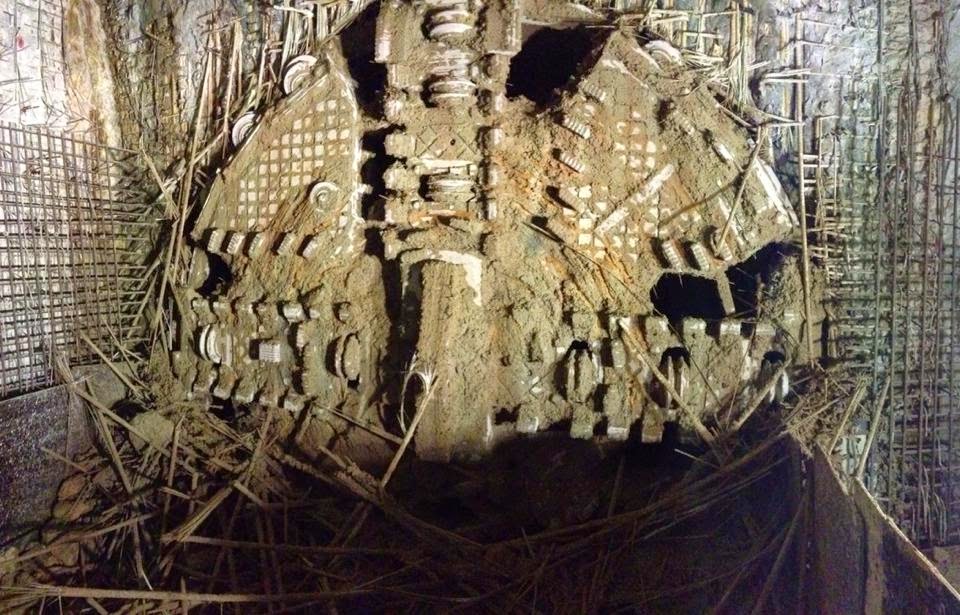

S687 Breakthrough at Kaki Bukit Station
Mined Cripple Siding at Bedok Reservoir
